This permit scheme gives us a way to manage street and roadworks activities on the public highway.
2. Permitting Applicable Area covered by the Permit Scheme
3. Registerable/Non-Registerable Activities, and Exemptions Activities covered by the Permit Scheme
4. Permitting – General Guidance
6. Permits – Review, Variations and Conditions
The purpose of this document is to explain and demonstrate the requirements set out by the Department for Transport (DfT) and to explain how Torbay Council is going to exercise their version of the Permit Scheme.
The Torbay Council Permit Scheme is a new way of managing requested access for use or excavation of the highway, developed in accordance with the DfT Statutory Guidance for Highway Permit Schemes (July 2022).
The Permit Scheme is designed using Part 3 of the Traffic Management Act 2004 (Sections B239)(TMA), the Traffic Management Permit Scheme (England) Regulations 2015m DfT Code of Practice for the coordination of street and road works (March 2023) and the DfT Code of Practice for streetworks inspections (March 2023) ).
Torbay will be operating a Single-Authority Permit Scheme, Torbay Council will be managing submitted permits in accordance with the statutory guidance and this policy.
EToN v6.0 is) is the term used for the two way transmission of notices between Statutory Undertakers and Highway Authorities in England and Wales. Systems and Techniques vary across the UK, Torbay operates EToN through Yotta Mayrise Streetworks.
EtoN v6.0 originally pre-determined that unconfirmed notices were classified as “denied” by the highway authority and as such, statutory undertakers were not granted permission to work, occupy or excavate the public highway. The Permit Scheme changes this, and as such; puts the responsibility on the authority to ensure that permits are answered within their pre-determined time scales and are either accepted or denied.
In return, changes to the charges system for the permit scheme encourage “utilities and statutory undertakers” (to be referred to as “Promoters” to assess the impact that their work has on the highway network and to reduce the amount of time they occupy the network, as applicable charges must be sought by the authority for the administration of the permit scheme and the occupation of the highway.
The key changes to the Permit Scheme introduced in the Code of Practice for the coordinator of street and road works (March 2023) are;
The key objective of the DfT, and participating Highways Authorities, is to make the highway network more efficient in terms of traffic congestion and to minimise the disruption on the highway caused by vital utility works.
The Streetworks Permit Scheme Policy was developed in conjunction with PART 3 of the TMA and the Traffic Management Permit Scheme Regulations 2007, and has been designed in line with guidance from the DfT and Secretary of Transport which has set out the guidelines for authorities moving to the permit scheme.
The Streetworks Permit Scheme Policy will operate in accordance with the HAUC Guidance and Statutory Guidance for Highway Permit Schemes. The Streetworks Permit Scheme will be operated by Torbay Council, and within Network Management.
Rather than the industry standard term of “Statutory Undertakers” Torbay Council will now refer to those undertaking works on the highway as “Promoters” which will include utility companies previously referred to “Statutory Undertakers”, the Highways Authority itself and its Contractors (both Short Term and Long-Term Maintenance Contractors) as well as Private Undertakers works.
The area covered by the Streetworks Permit Scheme Policy is within the boundary defined areas of Torbay Council.
Chargeable Permits will apply to all sections of the carriageway defined as a “Street” below.
The Term “Street” refers to any length of a highways carriageway asset associated with a ‘Unique Street Reference Number’ (USRN), and where by a site intersects more than one USRN, an application for multiple permits will be required; one for each USRN concerned.
Streets or section of Streets with a USRN which are not Publicly Maintainable/Adopted do not require a permit, however permission must still be sought by the owner of the Street. If works on a “Private Street” fall outside of the Private Streets Boundary and USRN into a street which is publicly maintainable, then a permit must be applied for.
Streets which are not currently listed with USRN do not require a permit for works.
Torbay currently has no Trunks Roads or Motorways under its jurisdiction.
The Streetworks Permit Scheme will apply to all adopted and publicly maintainable streets.
Torbay Council currently operates a Street Gazetteer, and this information is published through GeoPlace.
Streets which are not covered by the Streetworks Permit Scheme are defined below
The following activities or works are registerable for all promoters and will require permitting on “streets” as defined above;
The Permit Scheme covers both Statutory Undertakers and Highway Authorities (and their Promoters) However, Direct Highway Authority works (by itself, subcontractors or promoters) will not be charged the permitting fee.
Ruling on classification of works and sensitive streets will apply to all works, regardless of undertaker or promoter.
The following activities are non-registerable and do not require a permit.
A Promoter can start work before applying for a permit, providing that they apply for a permit within 2 hours of work being undertaken, unless the work is undertaken out of hours, then a permit application must be submitted before 10am the next working day.
Activities which involve a Section 50 under the ‘New Roads and Street Works Act (1991)’ (NRSWA) are covered by the Streetworks Permit Scheme; a new Section 50 Licence must be applied for, and the use of Road Space and excavation are to be applied for as a “Permit” under the Streetwork Permit Scheme.
Any Promoter looking to undertake any activity that requires highway space, or excavation needs to obtain a permit from the permitting authority (in this case, Torbay Council) The Permit, when granted by Torbay Council will allow the Promoter to
A single Permit application can only be for a single street, which applies to a single USRN. Whereby an activity or phased work affects more than one USRN, a permit will be needed for each activity, per USRN.
Discounts may be applied where applications or works are phased or grouped together.
Only one permit can be submitted for one phase of works or activities. A phase is defined as “an activity or scheme of works which results in the continuous occupation of a street.”
As such, separate permits would be required for works for temporary or interim reinstatements. The dates submitted as part of the permit application and in the agreed permit will denote, and where multiple permits are submitted for different phases of works, these works must have the same works reference and be related to the other phases.
SWISCo working on behalf of Torbay Council operates four key management systems for traffic information sharing.
All works including traffic management details are resigstered on Causeways Mayrise Streetworks.
The Causeways system interfaces with Street Manager via API to send information to and from undertakers.
One.Network interfaces with Mayrise via API and displays traffic management information through their own portal and associated portals
Consultees and internal notification of works are notified through the Roadworks Report system.
Interruptions or Delays to works will be the responsibility of the promoter; the promoter will be required to contact Torbay Council in the first instance, and it is to be agreed with the Streetworks Coordinator on what action should be taken.
Potential Actions to be considered:
The decision on the potential actions will be considered using a variety of factors such as;
Where Works or Activities cross a boundary between two authorities, two permits will be required; one for each authority.
Whereby cross boundary activities operate different processes for streetworks, one as NRSWA and one permitting, then the two authorities must collaborate to agree on the ruling for timing and restrictions.
A single project reference should be included for all phases, applications, notices/permits, so that both authorities can correctly consider the impact of the works.
One of the key aspects of the Permit Scheme is the encouragement of collaborative working on both Streetworks and Authority Schemes. Every opportunity should be taken to ensure that collaborative working can be done.
Where an agreement is made between two promoters to undertake collaboration; one promoter should be the lead promoter with responsibility for the activities and will be the primary point of contact for the authority. The details required of collaborative working should be:
Where works are required after the expiry of a permit, an application should be made for a new permit, with reference made to the previous permit using the works reference number and phase number.
Starting and Ending of Works
For roads which meet the following criteria
The start and end dates submitted with the permit are the commencement and finish dates, Permits are not valid outside of these dates, unless a variation is granted with co-ordination from the Streetworks Coordinator.
For roads which meet the following criteria
The Start Date is designated as a “proposed” start date, which can be altered with 5 Days either side as long as the change is agreed between the Streetworks Coordinator and no significant effect to Traffic flow will be anticipated.
Where ‘Early Starts’ are considered, the promoter will have to submit a variation to the authority with a revised start and end date.
The permit should be of the same duration as initially submitted, with a revised start and end date. Should the original permit submission be already confirmed, then a variation charge may be required.
It is at the discretion of the authority to grant early start permissions, reasonable considerations should be taken to ensure minimal disruption caused by an early start.
Where works may overrun their duration or permitted area, it is the responsibility of the promoter to alert the permitting authority to this at the earliest instance.
Where works will be considered for an extension, a fee will be applied as well as a variation fee. The authority reserves the right, where it is reasonable to instruct the promoter to temporarily reinstate the site and return when a newly submitted and agreed permit is issued, once proper warning has been given to the authority and traffic user.
Where an overrun or occupation of site exceeds the agreed permit duration without any notification, a penalty will be applied in accordance with Section 74 of the NRSWA, as well as a variation cost to change the permit dates, and the authority reserves the right to charge a site attendance fee to the promoter.
If works are found to be undertaken without a permit submission, and are found to not be of an urgent nature, then the permit authority will assign the promoter a fixed penalty notice, as well as a site attendance fee. A result of this may be that the site is closed immediately, and if not possible, then the promoter will have to temporarily reinstate the site immediately and apply for a permit and be liable for all associated costs.
There are two types of Permit covered under the Permit Scheme
1. PAA – Provisional Advance Authorisation
2. Permit
A PAA is used in place of an advanced notice under the NRSWA, and is used as an advanced permit to warn of Major Activities, to enable the authority and its Streetworks officers to appropriately coordinate, plan and identify the needs of the public, while the proposed major works are undertaken.
In order for a PAA to be considered, the following criteria must be met:
There are 4 key classes of Permit, covered under the Permit Scheme.
Further to these two designations, there are 3 sub-categories which will affect how “major works” are defined
A major activity may be subject to individual conditions set out by the authorities’ Streetworks Coordinator or permitting officer, these may include restrictions on working times, which will be pre-agreed with a promoter.
Standard Activities are activities that have a planned duration between 4 to 10 days duration inclusive. If works last less than 10 days, but require a ‘Temporary Traffic Regulation Order’ (TTRO), then they shall be classified as Major Works and will be subject to the rules set out in Major Activities
Standard Activities shall be submitted within the allotted timescales and shall include the following details
A standard activity may be subject to individual conditions set out by the authority’s Streetworks Coordinator or Permitting Officer, these may include restrictions on working times, which will be pre-agreed with a promoter.
Works which last 3 days duration or less; however if works last 3 days or less, but require a TTRO, then they shall be classified as Major Works.
Minor Activities shall be submitted within the allotted timescales and shall include the following details
Immediate Activities are either:
Emergency or Urgent
Emergency Works are defined in Section 52 of the NRSWA
Urgent Activities are defined as works undertaken:
Works that are considered as Emergency or Urgent can commence without a permit, however where an excavation is necessary, the promoter should contact the Authority immediately by Email or Telephone and then in any case, the Promoter must apply to the permit authority within 2 hours of the activity starting.
Permit class - activities | Provisional Advance Authorisation (PAA) | Permit application | Minimum period before permit expires to apply for variations* |
---|---|---|---|
Major | 3 months | 10 days | 2 working days or 20% of original time |
Standard | NA | 10 days | 2 working days or 20% of original time |
Minor | NA | 3 days | 2 working days or 20% of original time |
Immediate - urgent or emergency | NA | 2 hours after work commences or ends | 2 working days or 20% of original time |
Permit class - activities | Provisional Advance Authorisation (PAA) | Permit application | Minimum period before permit expires to apply for variations* |
---|---|---|---|
Major | 1 month | 5 days | 2 working days |
Standard | NA | 5 days | 2 working days |
Minor | NA | 2 days | 2 working days |
Immediate - urgent or emergency | NA | 2 days | 2 working days |
*whichever period is longer
The authority reserves the legal right to refuse a permit or request a permit application modification where they deem that elements of the permit are unacceptable or not feasible.
The authority will abide by “contact timings for response to Permit Applications” set out in Table 2 and provide an adequate response or reason as to why the refusal or modification has been requested, this information may be used to resubmit or modify the application by the promoter to allow a successful granting of a permit application.
Where the Authority identifies an error with a permit application, it will either; depending on previous discussions and the scale of the error:
Whereby the promoter sends a modification request, the promoter should include any details of agreed verbal agreement between the authorities staff and the promoter’s staff.
Torbay Council recognises the Department for Transport 2015 guidance; the nationally agreed conditions and, will adopt any approved changes set out and issued by the DfT.
View the statutory guidance document.
If Torbay Council considers that a Promoter is failing to comply with the conditions of a Permit, then they may revoke the Permit.
Should this be considered, then a Permitting Officer will contact the Promoter to inform them of the intention to revoke the Permit and begin discussion, and depending on the severity and risk presented in the Breach, the Permitting Officer reserves the right to completely close a site.
Any Promoter applying for a Permit should bring all issues or conflicts with conditions to the attention of a Permitting Officer at the earliest opportunity.
Permit Granting will be issued electronically through Torbay Council’s Streetworks Management System, which is currently Yotta Mayrise. The Authority will endeavour to meet the time scales for responses listed above in
Permit Refusals will be issued electronically through Torbay Council’s Streetworks Management System, which is currently Yotta Mayrise, an explanation of refusal will be given.
The Promoter has the right of appeal, which is set out below in Dispute and Appeals if an agreement cannot be reached with the Permitting Officer
Should activities be stopped by a Permitting Officer, then a defined reason and evidence will be issued, including any associative legislation.
Torbay Council is required to reply within the Timescale for an application for a permit. If the authority fails to do so, the Permit is deemed “approved” or “granted” under the full terms of the Permit Application.
In such cases, all details pertaining to the Permit Application will be deemed accepted. There will be no fee applied when Permits are automatically “Deemed to be to Approved.”
Once the permit has been accepted or approved, the Promoter should have reasonable confidence and expectation that the road space will be available to them during the approved period.
Torbay Council will avoid, wherever possible, to seek to make changes to an already approved permit, however circumstances outside of Torbay Council’s control will inevitably mean that a small minority of permits will need to be changed. These events may include
These circumstances may mean that the occupied road is closed, or the occupied road may be used as a vital traffic diversion route.
If at any time such instances should occur, Torbay Council will contact any affected promoters immediately, and a variation or revocation may be discussed, and may be submitted with no charge.
Any activities that run past the agreed permit period will be committing an offence under Section 74 of the NRSWA 1991 and the Promoter will be charged if they do not have a reasonable excuse for additional occupation and not notifying Torbay Council.
Within the Permit Scheme, Torbay Council has the power to review, vary or revoke permits on its own initiative or on behalf of the Promoter. Torbay Council is under no obligation to allow Promoters activities to run past the permitted dates.
If a Promoter wishes to withdraw or cancel a permit, they must do so through an electronic management system.
Permits cannot be “lengthened” or “shortened”. In any case where a change is needed, a variation must be submitted.
Permits cannot be “postponed” or “delayed”. In any case where a change is needed, a variation must be submitted.
Where an immediate activity takes place, the promoter must submit a permit within the required timescales.
Some immediate activities may require more than one single excavation, where fault finding is necessary. The first application should therefore note the initial location.
Where a variation cannot be agreed, Torbay Council will issue an Imposed Variation on the terms that the Permitting officer deems reasonable.
If the Promoter disagrees with this, they have the option to invoke a dispute resolution.
Where Torbay Council believes that a Promoter is failing to comply with conditions of a permit, they will collect evidence of the issue and where they are satisfied conditions have been breached, shall either:
The Promoter will be warned of any impending revocation in such cases.
If the Promoter refuses to cease activity where instructed to do so (except to secure site or temporarily reinstate), it will be classified as an offence and any penalty or prosecution will be pursued by Torbay Council.
This section covers the reasons, criteria, process and the extent of the powers that the authority can exercise to ensure that all restrictions are compliant, identifiable and any conflicts with future planning or works are avoided.
The purpose of a restriction is to protect the highway asset following substantial works.

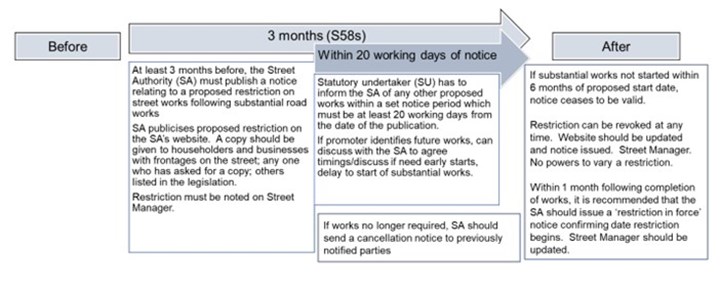

Using the DfT Code of Practice March 2023, it is important that to understand that both Statutory Undertakers and the Higghway authority should work cooperatively to ensure that notification of works and restrictions are both executed with consideration to each others assets needs.
‘Section 59 – A street authority shall use their best endeavours to co-ordinate the execution of works of all kinds (including works for road purposes) in the streets for which they are responsible.’
‘Section 60 – An undertaker shall, as regards the execution of street works, use his best endeavours to co-operate with the street authority and with other undertakers.’
Restriction category | Section of the NRSWA |
---|---|
Restriction on street works following substantial road works | Section 58 (as modified for the purposes of permit schemes by regulation 37(2) of the 2007 permit regulations) |
Restriction on street works following substantial street works | Section 58A and Schedule 3A (as modified for the 42 purpose of permit schemes by regulation 37(9) of the 2007 permit regulations) |
Section 58 powers should be exercised by the authority when the following criteria are met as per the Code of Practice
1) For the purposes of section 58(1), substantial road works means works for road purposes which comprise a reconstruction, widening, alteration in the level, resurfacing or specialist non-skid surface dressing of the part of the highway concerned and which if carried out
Please note, both criteria in (a) (i) and (ii) or (b)(i) and (ii) must be met whilst the road works are in progress
Schedule 3A of the NRSWA defines “substantial street works means major works”
Major Works is defined as
All promoters should submit future work programmes to allow early discussion around substantial works using the Code of Practice flow chart below.
Statutory undertaker (SU) has to inform the SA of any proposed works within a set notice period. This must be at least 20 working days from the date the notice was published.
If promoter identifies future works, the promoter can discuss with the SA to agree timings or discuss if early starts or delayed starts of substantial works are needed.
If works are no longer required, SA should send a cancellation notice to previously notified parties.
If substantial works are not started within 6 months of proposed start date, the notice ceases to be valid.
The restriction can be revoked at any time, carried out via Steet Manager. The website should be updated and a notice issued. A restriction cannot be varied.
Within one month following completing of works, it is recommended that the SA should issue a “restriction in force” notice confirming date restriction begins. Street Manager should be updated.
The only valid restrictions recognised should be recorded through the Section 58 Management Tool on Street Manager and Advertised on the Authority’s website.
An in-force restriction may be revoked at any time if circumstances change and mean the restriction is no longer required. Revocation should be carried out via Street Manager by cancelling the restriction in force, as well as updating the authority’s website and notifying other prescribed parties.
Using the Code of Practice March 2023 and 2007 Noticing regulations, the maximum duration of restrictions are defined below.
Works type | Traffic sensitive reinstatement category 0, 1 or 2 | Reinstatment category 3 or 4 |
---|---|---|
Reconstruction | 3 years | 3 years |
Resurfacing | 2 years | 2 years |
It is recognised by the DfT and Authority that necessary works will need to be undertaken outside of the Section 58 Restriction.
These works are exempt from the Section 58 Restriction.
Sanctions will be considered by Torbay Council against Promoters that “Operate without a Permit”
It is a criminal offence for a Promoter or Sub-Contractor operating on behalf of a Promoter to operate without a permit (except where works are classed as immediate or emergency and a permit is to be submitted)
The following actions shall be sought by Torbay Council against a Promoter or Sub-Contractor operating on behalf of a Promoter, operating without a permit, using the following steps
Step 1 and 2 may include; Closure of Site and either temporary reinstatement or measure to make the site safe. The promoter should then re-apply for a permit to return at a suitable time to undertake works.
Any other offences relating to breach of NRSWA 1991 may still include separate fixed penalty notices or actions.
Regulation 30 gives Torbay Council the power to charge a fee for the following processes. Fees will be charged for the following
Fees will not be charged for the following
Discounted Fees will apply to the following, the rate of discount will be 30%
Torbay will review its permit fees on a 3 yearly basis, to ensure that the overall fee income does not rise above allowable costs, and in return, Torbay Council has the right to raise fees, up to the maximum permissible level, set out by the DFT to fund the permit scheme.
Torbay Council will seek to manage fee systems as efficiently as possible, but whereby overhead costs surpass charged fees, Torbay Council will seek to raise fees to cover the extra expenditure incurred, this will not exceed the maximum allowable costs.
The Annual Fee Review will take place (2025).
Costs of Fees will be calculated automatically by Causeways Mayrise.
A monthly invoice will be produced by a Permitting Officer and forwarded onto the Promoter via their preferred means of communication.

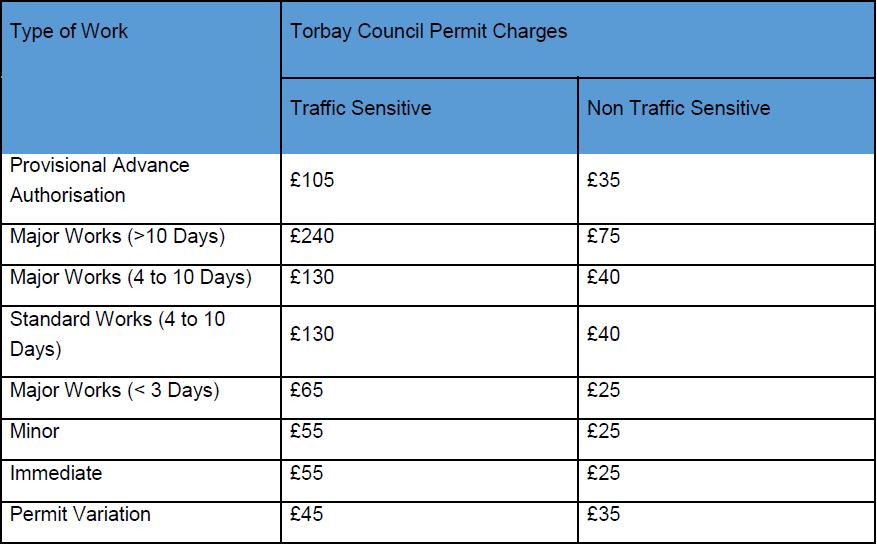

Type of work | Maximum permit charge (DfT guidance): traffic sensitive | Maximum permit charge (DfT guidance): non-traffic sensitive | Proposed Torbay Council permit charges: traffic sensitive | Proposed Torbay Council permit charges: non-traffic sensitive |
---|---|---|---|---|
Provisional Advance Authorisation | £105 | £75 | £105 | £35 |
Major works (>10 days) | £240 | £150 | £240 | £75 |
Major works (4 to 10 days) | £130 | £75 | £130 | £40 |
Standard works (4 to 10 days) | £130 | £75 | £130 | £40 |
Major works (< 3 days) | £65 | £45 | £65 | £25 |
Minor | £65 | £45 | £55 | £25 |
Immediate | £60 | £40 | £55 | £25 |
Permit variation | £45 | £35 | £45 | £35 |
Inspection fees (in line with March 2023 COP) | National standard fees |
---|---|
£50 | £50 |
£120 (joint visit, remedial works in progress, remedial works complete - per unit of inspection) | £120 |
Torbay Council would like to commit to opportunities for discussion and collaborating together with Promoters to resolve working issues than resort to formal Dispute Resolutions.
Once a dispute has been opened, after 14 days if the dispute is not resolved, then it will be forwarded to HAUC England/SWHAUC.

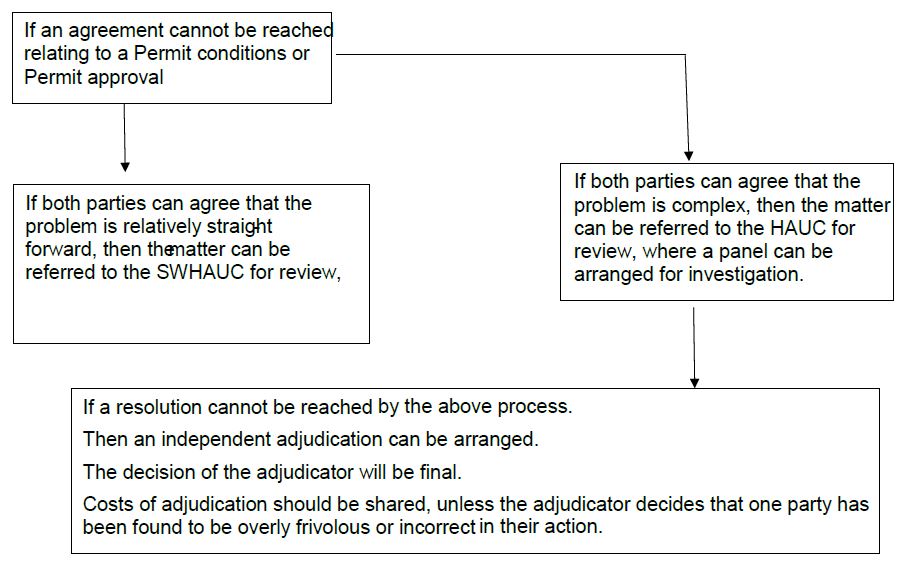

If an agreement cannot be reached relating to permit conditions or a permit approval, then:
Torbay Council operates an Electronic Streetworks Management system with Causeways Mayrise, this handles incoming and outgoing permits, as well as storing information.
The management system stores information on old, current and upcoming works, as well as information held under noticing and EToN.
Non-compliance in site inspections and reinstatements are found from Page 19 to 27 of the Code of Practice for Streetworks Inspections March 2023.
From April 1st 2023, the Code of Practice States that
If an undertaker has a failure rate lower than 15%, then a 30% sample rate will be applied for inspections carried out during the 1st quarter (April-July) of the financial year.
If an undertaker has a failure rate of 15% or higher, then a 50% sample rate will be applied for inspections carried out during the 1st quarter (April-July) of the financial year.
The failure rate is defined in the 2022 regulations as the percentage of an undertaker’s chargeable inspections of works which, in the year which began on 1st April 2022, failed to comply with the standard set out in whichever of the safety code or the SROH was applicable to the inspection category.
An inspection is deemed to have failed to comply with the standard where the undertaker and the authority have agreed that the standard was not met.
All sample inspections in categories B and C will be generated by Street Manager, with selection rules documented in the Street Manager business rules. However, due to the practical challenges of coordinating inspector movements with live site activities, category A sample inspections cannot be selected and programmed in the same manner. Therefore, authorities will be responsible for selecting sites to visit, ensuring the selection is as random as possible and includes works in all streets and permit types as appropriate.
